The Cost Tracker: A Job's Money (Admins Only)

This is the same guide SiteBot reads. Inside the app you can ask it any of this in your own words, and it answers from this page.

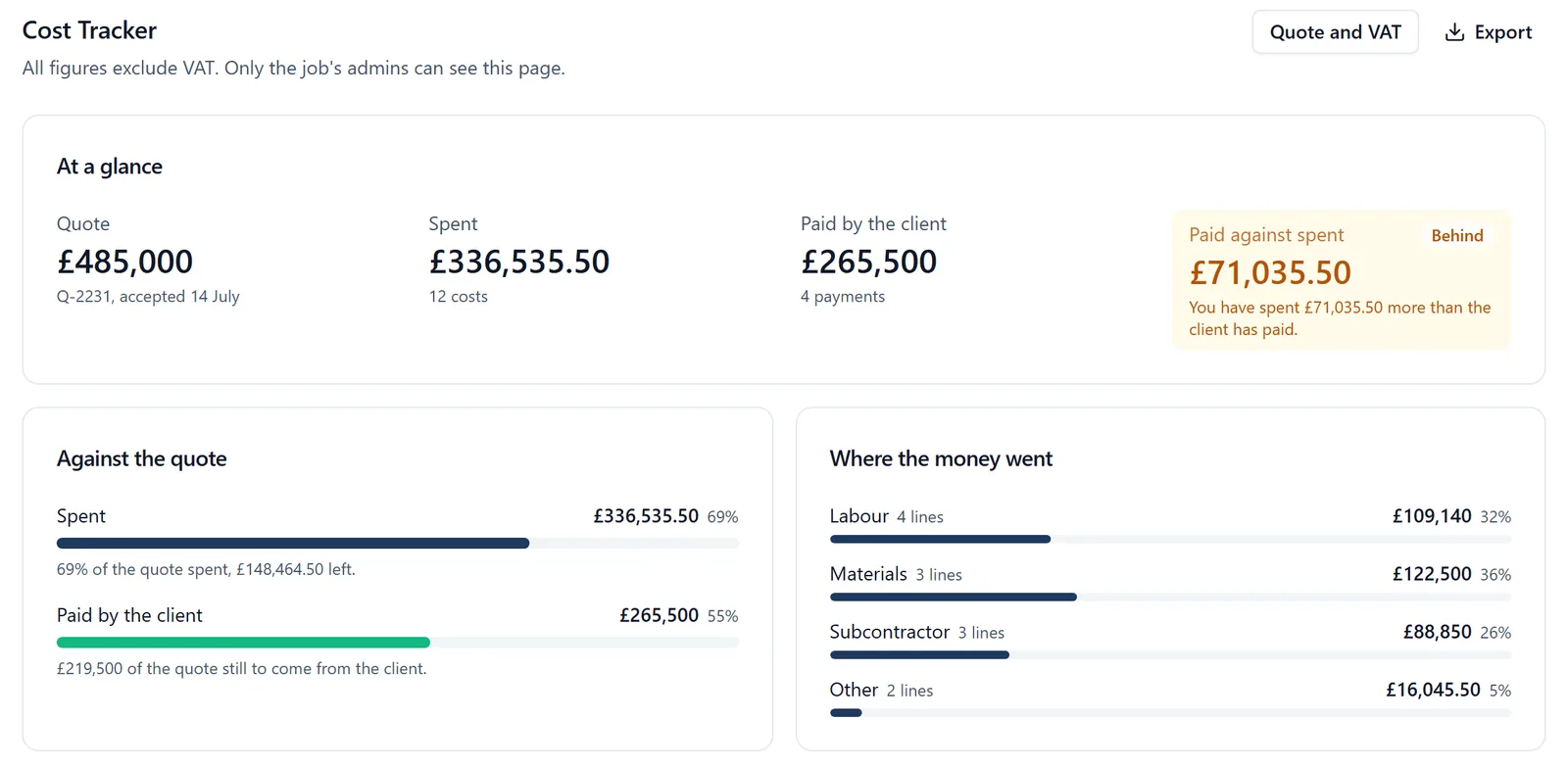

The Cost Tracker in a browser: All figures exclude VAT under the heading, then At a glance with a quote of £485,000, £336,535.50 spent across 12 costs, £265,500 paid by the client across 4 payments, and an amber Behind chip over £71,035.50 with the sentence You have spent £71,035.50 more than the client has paid; below it, Against the quote with a bar for Spent at 69% and one for Paid by the client at 55%, and Where the money went split into Labour, Materials, Subcontractor and Other.

The Cost Tracker keeps one job’s money in one place: what the job was quoted at, what has been spent on it, and what the client has paid. It answers the question a spreadsheet per job used to: are you ahead of the client on this job, or are you carrying it and is it time to invoice? It is for the job’s admins only, and it is a browser page: there is no Cost Tracker on the phone.

How to get there (app.buildersai.co.uk):

  1. Open the project
  2. In the sidebar on the left, under the Admin heading, click Cost Tracker. It is the last entry in that group
  3. On a brand new project the sidebar is shortened, so the Admin group is behind “More” at the foot of it until the project is set up

Who can see it: only the job’s admins. The owners and admins of your company are admins of every job by default, so they see it on every job. Members and followers never see a figure: the entry is not in their sidebar, the page tells them it is not theirs, and the figures are never sent to them, not to their phone, not in an export, and not through me. I can tell anybody how the Cost Tracker works, but I cannot read its figures for anyone, admins included, so for the numbers themselves open the page.

Before the first figure: the quote, and VAT

Click Quote and VAT at the top of the page (or Record the quote on a job with nothing recorded yet).

Recording what has been spent:

  1. In Costs, click Add a cost
  2. Choose the Category: Labour, Materials, Subcontractor or Other
  3. Choose the day it was spent, say what it was (for example “Carpenters, week 3”), and type the amount, on the job’s VAT basis
  4. Click Add cost

Recording what the client has paid:

  1. In Payments received, click Add a payment
  2. Choose the Type: Deposit, Stage payment or Invoice paid
  3. Choose the day it was received, give the reference it was paid against (for example “INV-0042, stage 2”), and type the amount
  4. Click Add payment

Type amounts as you would write them: 1250, 1,250.50 or £1,250 all work. Every amount is above nothing: to record a credit or a refund, correct the line it credits.

At a glance:

Against the quote puts spend and payments side by side on the same scale: how much of the quote has been spent and what is left of it (or how far over it the job has gone, in red), and how much of the quote is still to come from the client. Where the money went splits what has been spent into Labour, Materials, Subcontractor and Other.

Correcting or removing a line: every line in the two lists has a pencil to change it and a bin to remove it. Removing asks first, and names the line in full with its amount and day, because two payments often share a description. Every change, including a removal, is kept in the project’s audit trail.

Exporting it: Export at the top of the page downloads the job’s money as a spreadsheet, oldest first: the date, cost or payment, the category, the description or reference, and the amount, with money out and money in in separate columns so each sums on its own. The top of the file says which job, the day it was exported, the VAT basis, the quote and the totals.

When the project is read-only (the company’s trial has ended or its subscription has lapsed), every figure stays on the page and the export still works, but nothing can be added, changed or removed until a plan is chosen. The heading says why.

What it does not do (yet):
